Tuesday 26 November 2019

Splitting up

Monday 25 November

So much to do and so little time, we split into 2 teams to day; Andrew and Stuart went to Stanton to start on the yard rearrangement; Roger, Alastair, Dave and Nigel went to Hailes to work south doing Culvert clearance. Then in the afternoon it was down to Dixton for some tidying up jobs and to retrieve the plank stuck in Culvert 33A.

First today there's the report and photo's from Alastair starting at Culvert 17B, one of the more awkward to clear because of the steep sides.

Culvert 17B down side before clearing
Culvert 17B up side before clearing
Dave clearing the up side of 17B
Nigel and Roger on the up side of 17B
Nigel and Roger working towards the occupation bridge that borders the railway
Culvert 17B down side headwall cleared
Coffin shaped barrel on Culvert 17B
Dilapidated occupation bridge, not a GWSR asset 😌
Dave starting on Culvert 18A down side
Culvert 18A up side cleared
Culvert 18A, level drop in the chamber
Culvert 19A up side, Oh! if they were all like this 😊
Culvert 19A internals
Dave clearing Culvert 19B down side

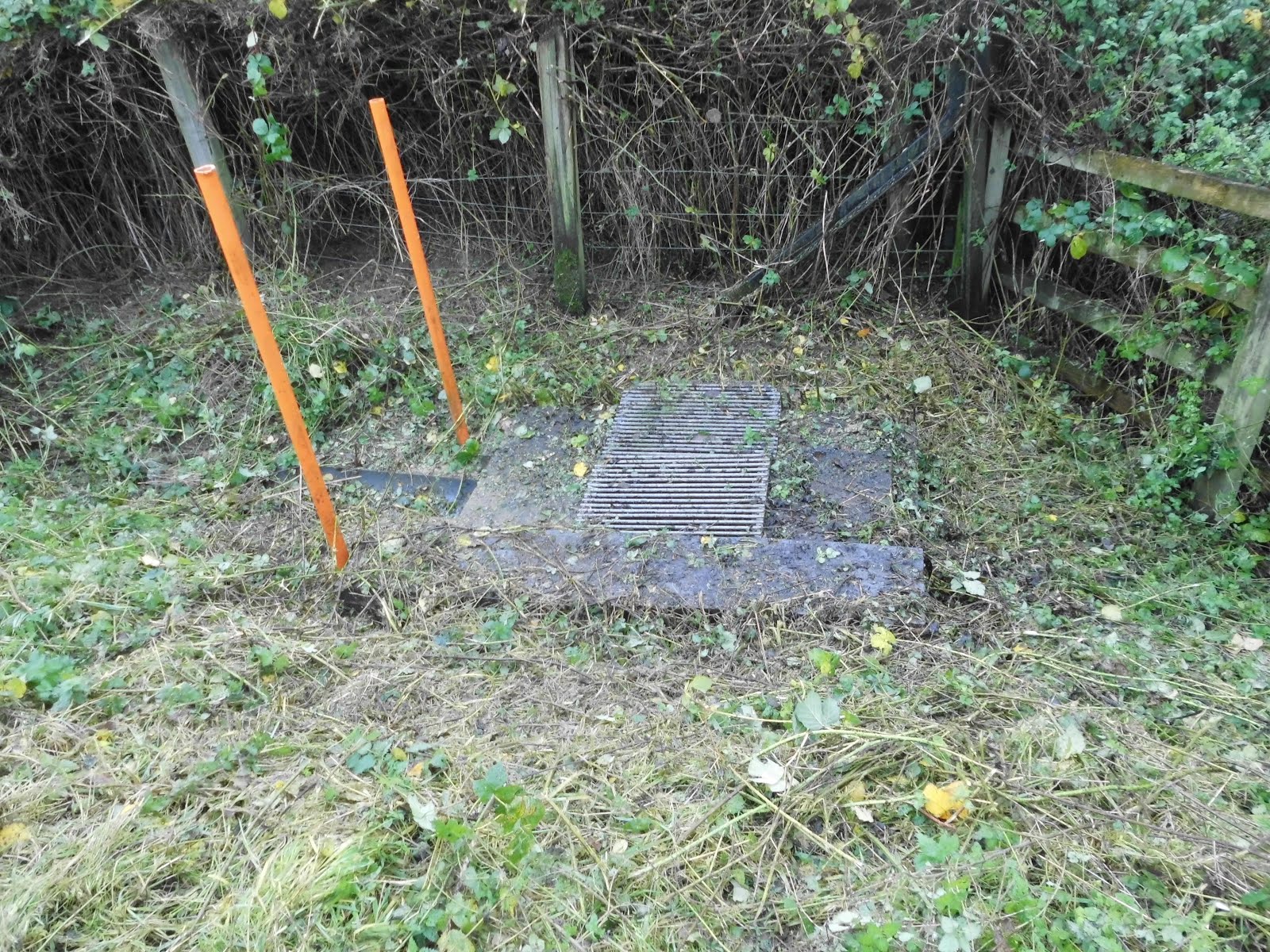

19B has the orange poles to protect it from flail damage
Culvert 20A down side
Roger clearing round the gully under Bridge 20
Culvert 20A extended inlet
Culvert 20A, brick headwall visible beyond the twinwall pipe

Where culverts have been extended it's usually because the embankment has slipped and overwhelmed the original headwall. Eventually we will get around to adding headwalls or re-profiling to get back to the original headwall.

Down at the bottom of Defford Straight just before Chicken Curve the cess drains run out on each side, small headwalls were built last year.


Nigel clearing the up side cess outfall
Chicken Curve, Culvert 20B up side
Chicken Curve Culvert 20C down side
Culvert 20C extended with twinwall pipe, in need of jetting

Up at Stanton, the intrepid duo managed to dodge the rain by returning to Winchcombe to collect the generator and breaker to pulverise some concrete so that it's easier to handle. Work is planned to on the viaduct drains over January and February next year. The yard at Stanton will be used for storing materials hence the need to make space and see if we can sort out what's there. The waste hardcore pile was first on the agenda...


Waste hardcore pile

Going...
It looks too easy
16 tonnes removed, still some left

The sides of the yard have got a bit overgrown, the problem for clearing is the stored rail and other equipment is in the way!

What's in here?
A pile of concrete sleepers
Another store of rail
Andrew breaking blocks
Remains of a grit bin
Andrew brushcutting round the top of the yard

After lunch it was off to Gotherington and Dixton, a longstanding job to replace a heavy concrete slab with our newly manufactured lids was completed.

New lids on Culvert 33A up side chamber
Dave posing with the plank rescued from Culvert 33A outlet pipe

At the 3 arch bridge over Dixton cutting there is a crest drain that runs down into the cess, this has an unusual arrangement of 2 pipes taking the outflow down the slope.

Bridge 33 Dixton, down side crest chamber
Bridge 33 down side crest chamber, outlet on the left

We've more more jobs lined up for Thursday, hopefully it will stop raining soon.
