Friday 10 January 2020

New year, new projects

Monday 6 January

The new project mentioned in the title is clearing the drainage pits on Stanway viaduct, more on this at the end of the blog. Otherwise it was back up to Stanton Yard this morning to do a bit more clearing up then down to Southam Lane to install the drain on the wing wall at Bridge 42.

Stanton Yard, the old container is destined for the scrap heap
it's got terminal rust in the roof

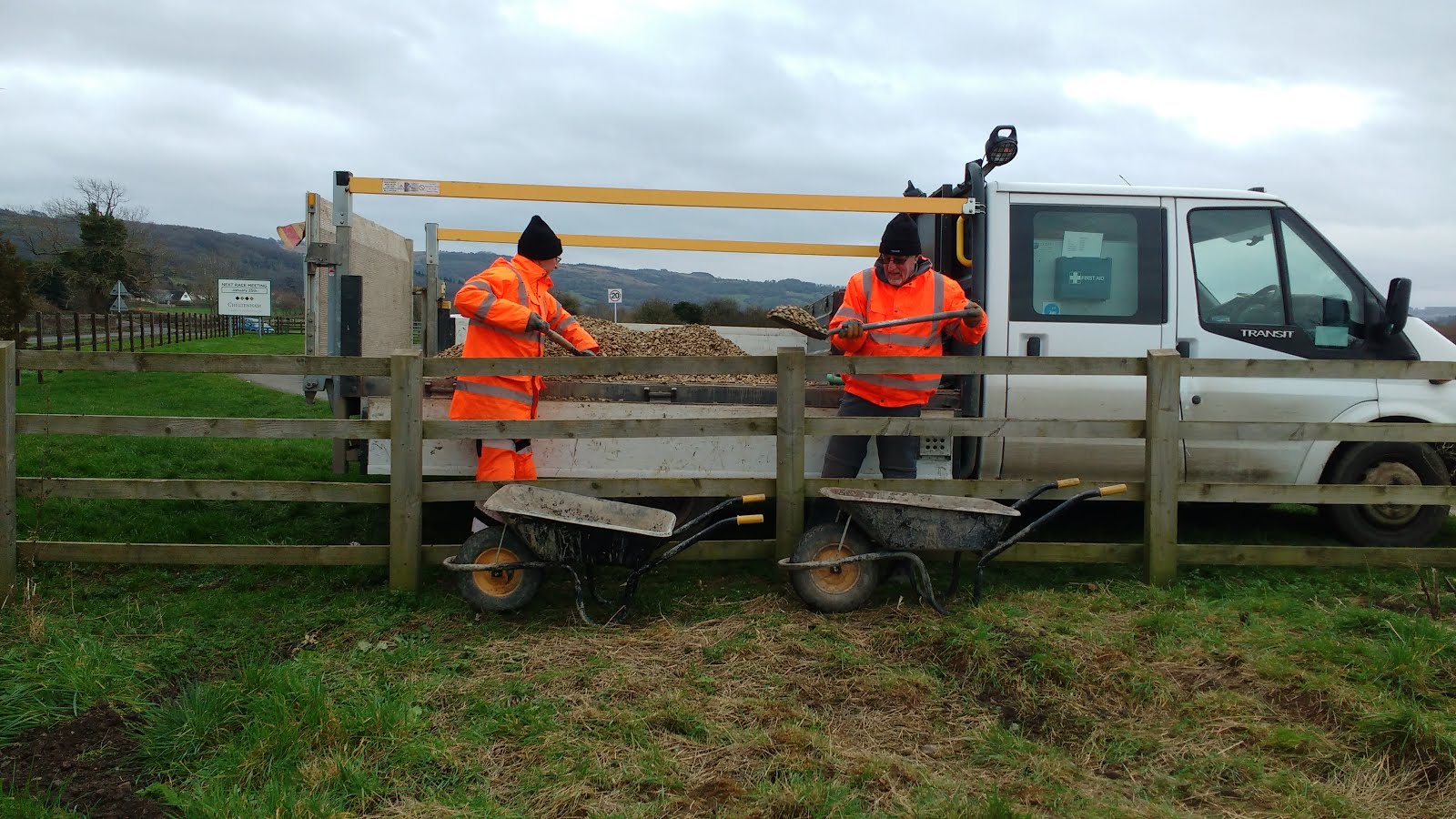

Down at Southam Lane, the first load of gabion stone is dropped into the abutment drain

Bridge 42 down side abutment
(Photo: Roger)
Bridge 42, down side low mileage wing wall
Roger laying the Terram to wrap the drain pipe
Dave and Nigel unloading the pipe bedding
The 100mm plastic drain pipe is weighted down with pipe bedding
and then the Terram is wrapped around the top
Bridge 42 wing wall drain progressing
Bridge 42 wing wall drain backfilled with pipe bedding stone


We did some further investigation of the drain from the crest, the pipe running into the cess chamber is badly coated with calcite, about 50% pf the diameter has gone.


Bridge 42, Pipe from the crest
Inside the crest pipe, calcite (Limescale)
Limescale is coating the side of the chamber
where water has run in through the rings


Wednesday 8 January

Surveyors came in to do a topographical mapping of the cutting at Winchcombe, Andrew was in to escort them and ensure everything ran smoothly

Datum point set up on Greet Bridge
(Photo: Andrew)
Working on the up side slope
(Photo: Andrew)
Measuring along the fault line at the crest
(Photo: Andrew)
Winchcombe Cutting up side slip area
(Photo: Andrew)


Thursday 9 January

Out and about day, a quick look up a the River Isbourne and then down to Cheltenham to survey the drains on the down side crest at Hunting Butts. On the way back we went to Stanway Viaduct to have a look at the drainage pits that have been excavated by our contractors as part of the viaduct drainage upgrade works.


Culvert 21A up side bank erosion control measures
The bank along the house garden will be protected in a later stage
Culvert 21A toe drain outlet from Chicken Curve
Culvert 21A up side headwall
Culvert 21A up side, station cess drain outfall still to be completed
River Isbourne downstream of the railway

Work is starting on the down side, the right hand bank (the station side) has suffered most form the scour as the river moved from it's original straight line.

Culvert 21A River Isbourne down side

We stopped off at Gotherington on the way to Cheltenham to have a look at the up side slip near Bridge 37. It seems to be stable at present, possibly waiting for the next rain

Up side toe drain chamber near Bridge 37
Up side fault north of Bridge 37, still at 1.5m

There's a couple of drains along the down side crest between Evesham Road bridge and Hunting Butts. These drains are in a poor state following years of neglect. A section of pipe was replaced in August 2016, but more work is required before the new fencing is installed.


Hunting Butts crest drain chamber 1
18" pipe running to the cess
Michael about to measure Chamber 1
The crest ditch has almost disappeared
Micheal and Dieh negotiating the swamp on the crest
Dieh probing for any signs of a pipe
What must be the low point has been cut off from a down pipe
Water overflowing down the slope
Chamber 2 mangled by the vegetation flail
Pipe running south from Chamber 2
in need of slight attention 😒
Pipe running on the surface into Chamber 5 sustained damage

Up at Stanton the contractors have started to clear around the 14 drainage pits on the viaduct. The holes that let water flow from the deck into the pits have been blocked causing water to seep into the structure. The mainly ash sub-base is being removed and replaced with a hard limestone, this is being brought in from Clee Hill in Shropshire.

Stanton Yard, spoil heap after 3 working days
Stockpile of limestone sub-base
Sleeper pile from the removed track
Viaduct rails laid out
Stanway Viaduct without track, drain work going south to north
Drainage pits above each arch and surrounding area dug out
Pit 5 just been exposed, the fine ash is blocking the inlet holes at the base

Pit 1 exposed and cleaned, drain hole rodded clear

The pits have 4 square holes to take water the collects on the water proofing (a tar layer protecting the structure below). The pit has sump with a single pipe running out of the arch below to drain the water

Inside a drainage pit, sump exposed
Drainage pit showing the inlet hole at deck level
Under the arch, the outlet pipe has left streaks
of white limescale
