Wednesday 22 January 2020

More investigations

Saturday 18 January

It was another day of out and about, Roger, Michael and Dave started off by clearing along the down side fenceline on Winchcombe cutting. Walsh Construction were on site to open a trench for us to to install some extra drainage to stop the bank over-topping into the cutting should the rain continue. There was a site meeting with the consulting engineers at Gotherington to discus what option are open to us to stabilise the embankment slip to ensure that trains can start running again in March. After lunch we all headed down to Bridge 29 at Stanley Pontlarge to look at another site that has severe drainage problems. One of the drawbacks of the lineside clearance team clearing the embankments is that we can see the problems the the vegetation has been hiding. It's a win for them, but more work for us 😒

The geologist on site today took one look at the hill behind the slip at Gotherington and spotted that it has a dish shape signifying that there had been a very big slip long before the railway had been built. The remains of ridge and furrow agriculture still visible shows that the slip must have pre-dated railway, even pre-dated the middle ages! The core samples taken show that the embankment was built by the GWR directly on top of the ridge and furrow. This means that the embankment sits on alternating strips of clay and deep top soil on top of clay, the furrows channel rain water from the hill under the embankment; hence the instability. The bottom line being that embankment was built on unstable ground without anything to hold it in place. A multi-stage solution is being worked up, with only 7 weeks to service start stabilising the trackbed is the key concern.

Looking to Nottingham Hill from Bridge 37
Engineers on the slip site
Gotherington slip face
The toe drain chamber has disappeared

Back at Winchcombe, the team tackled clearance of the down side fenceline to expose the filled in ditch over the crest drain

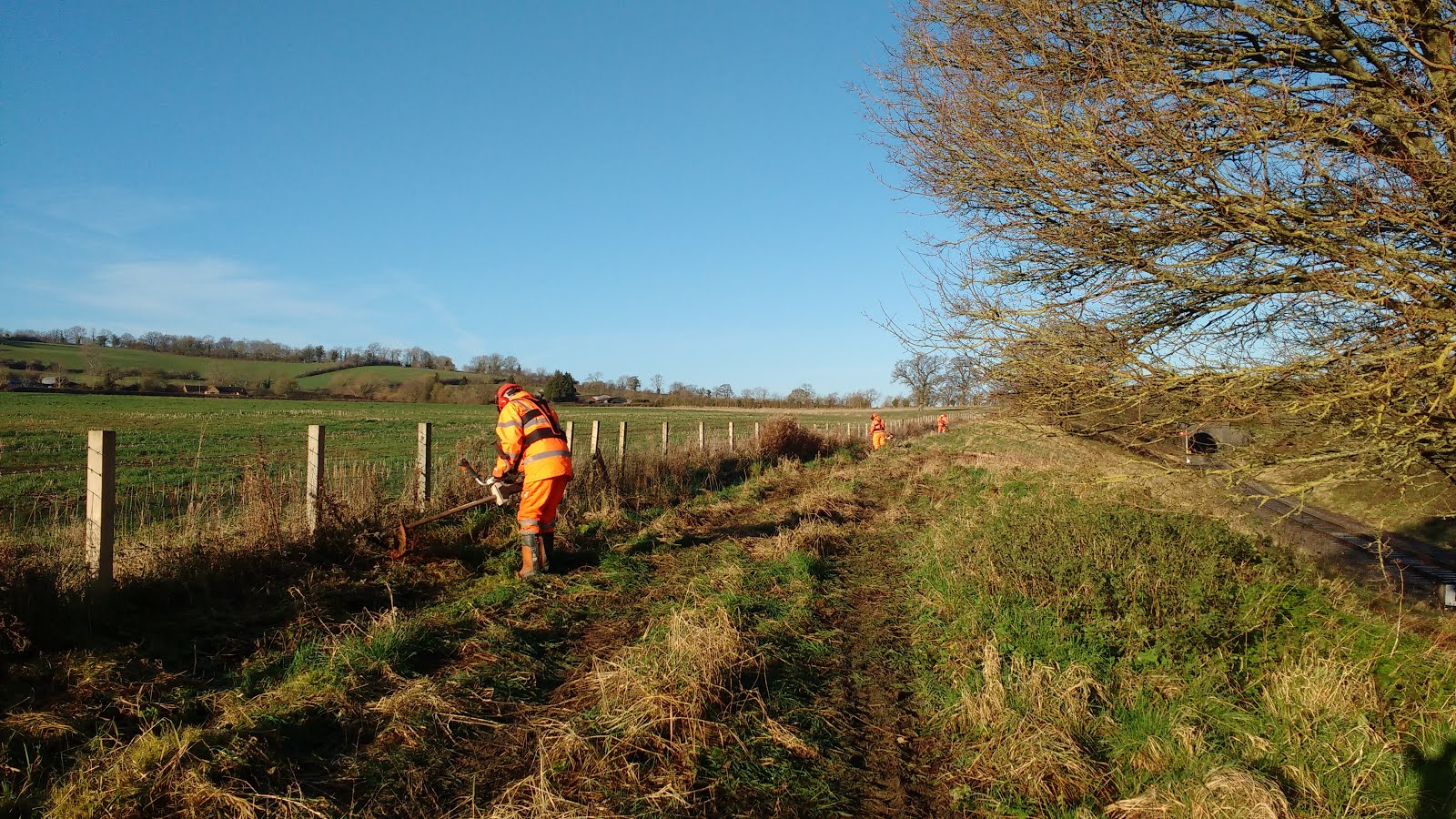

Michael with the brushcutter
Winchcombe Cutting up side, the emergency drains connected into the cess
Digger opening a ditch for the crest drain
New crest ditch excavation
Roger and Michael head north
leaving the brambles for Dave
(Photo: Dave)
The gang trudge back to the van for break
(Photo: Dave)
Down side fenceline cleared
(Photo: Dave)
Tree hugging
(Photo: Dave)

Down at Middle Stanley and Stanley Pontlarge the trackside has been flailed to clear the vegetation. This exposes the ground and lets us see where potential problems are building. We checked from Bridge 30 to the level ground between Bridges 28 and 29.

Starting at Bridge 30 looking towards Bridge 29
Down side toe drain has been overwhelmed by the recent rain
Stone topping on the drain scoured out round a tree
Toe drain inlet in a bad way
Arty shot through Bridge 29
Bund on the bottom end of a newly created lake uphill from the railway
Water ponding in the down side toe area
Signs of flooding over the fence
Dave trying to negotiate a way through the swamp
Line to Winchcombe
Up side looking to Bridge 29
Up side after Bridge 29
Culvert 30A up side, silting up


We had a go at trying to define if Culvert 30A runs under the road or under the low mileage abutment of the Bridge 30. It may well be half and half.


Tracing the line of Culvert 30A on the down side
Bridge 30 from the up side, the abutment slope out

Back at Winchcombe Carriage & Wagon have come up trumps again, we dropped the jockey wheel carrier from the flail in to the metalworkers this morning. This afternoon it's back fixed, the spindle has been welded back on. Thanks a million, departmental co-operation pays dividends 😊

Flail jockey wheel carrier welded

Another bit of departmental co-operation, our brick arch former from Culvert 11A has found a new vocation in Winchcombe Yard, it was spotted being used as a signal post precision support. A truly versatile bit of design 😂

24" brick arch former but to new use


Monday 20 January

Walsh were back on site at Winchcombe Cutting, the Isbourne work was still held up so we grabbed the opportunity to get the new 225 mm down side crest pipe plumbed in and backfilled. Steve was on hand with his tractor to bring some stone down from Stanton which made the job go even more efficiently. This left Dave, Nigel and Andrew at a bit of loose end, so they went up and cleared the drain channel above the tunnel portal. A 360 excavator arrived during the morning so that we can do some ditch clearance. In the afternoon we all headed off to Gotherington to measure up the slip. It's still on the move 😟

Still a slight movement on the up side of Winchcombe Cutting, we'll keep monitoring it.

Winchcombe Cutting up side the horizontal tree
Dave poses at the tunnel to prove that they got there 😃
(Photo: Andrew)

On the down side, the crest pipe along from the end chamber to beyond the gate was installed.

Measuring up with the new pipe
24" pipe down the crest, leaves no room to install the new pipe

As there's not enough room to break into the chamber, it was decided to break into the pipe with the new drain.

24" pipe exposed
Tidying up the trench
Hole cut into the 24" pipe to take the outlet from the new 225 mm
Stub pipe tried for size
Pipe bedding and top stone brought down from Stanton
New 225 mm crest pipe installed
Back-filling the new 225 mm pipe
Wrapping the pipe in Terram

In the field, it's clear to see where the water is coming in from, it runs down the field bringing silt in with it

Surface water on the field next to the down side fence

Down at Gotherington, the slip has moved further. Clear weather and frost make a change form the rains over the last 3 months

Looking over to a misty Malvern
Andrew with the measuring staff
1.8 m ranging pole near the face
The snout at the toe
The manhole has disappeared
Culvert 17A up side, toe drain dribbling in from under the slip

It looks like there may be a collapse in Culvert 37A, there is a hole under bridge 37 where gravel has been washed up above the culvert. Another job for the CCTV

Bridge 37, possible culvert collapse
Culvert 37A down side, toe drain running in
Possible spring under the hedge on the down side opposite the slip



4 comments:

  1. You guys have certainly got your work cut out, particularly if the Gold Cup business is not to be lost! Presumably the contractors will advocate driving in the steel "piles" as used at the Isbourne brook.

    Powli Wilson

    ReplyDelete
  2. So. once again, as at Chicken Curve, the original implementation was a quick hack, which has now failed. What a shock (sic)! Sigh, just as at CC, there's nothing for it now but to buckle down and do it 'right' - hopefully without quite the negative consequences in the meantime. About all one can say is that once these have been worked through, as with all the drainage works, the line will be in better shape than it _ever_ was, and ready to give years of service.

    Noel

    ReplyDelete
  3. It's doubtful if the later consequences of setting an embankment across medieval ridge & furrow fields would have been known nor considered by any of the railway builders, let alone the GWR. The much earlier Chat Moss route continues to be used although the tracks are floated on a bed of bound heather and branches topped with tar and covered with rubble stone. It continues to be high maintenance though!

    Piling was the method used by the F&WHR to extend the Boston Lodge works seaward. Steel shuttering driven through the ridge & furrow surface & deep into the subsoil below the slipped embankment should stabilise everything. It will be simpler than the problem faced by Network Rail. The 22nd December landslip on the line between Godstone & Edenbridge will keep the line closed for the foreseeable future, according to the Railway Herald. 40,000 tons of recycled ballast are to be delivered by 40 trains as the site is remote & almost inaccessible by road.

    ReplyDelete
    Replies
    1. It's estimated that we will only need 2,000 tons of stone for the slip repair, small job by comparison

      Delete
