Sunday, 1 March 2020

Soil nails going in at Gotherington

Monday 24 February

It was a wet start this morning so we took shelter in Carriage & Wagon to cut some wood to make new moulds for making 1800 mm chamber lids. The 900 and 1200 mm we made last year have been so successful we're venturing into bigger things. Next off was a trip to Bridge 37 slip at Gotherington to see if the drillers has got any soil nails in. Then it was back to Gretton for more fun at Royal Oak.

Dave and Martin cutting the sides for the second mould

The drilling rig is working at Gretton, there's over 300 nails to go in to stabilise the slip and the embankment at each side of it.

Soil nail insertion
Crack half way down the slope
Rabbits burrowed under the old concrete fillet, must be using it as a big lintel 😊
The ever growing snout at the toe
Driller at work


Round at Royal Oak there was more cess drain to clear, one patch had 400mm of building sand on top of the blocks, who knows where that came from; possibly the build of Gretton Halt years ago.

The Gretton sand pile
Dave and Martin taking levels along the down side cess drain
The level had to be moved every few chambers round the bend
Note: no trains running today so the is level standing in the track.

More run off at the trouble spot
Collection into the pipe not going too well

It's staggering the amount of spoil removed from the top of the drain, this is just to get to the blocks which should have been left exposed

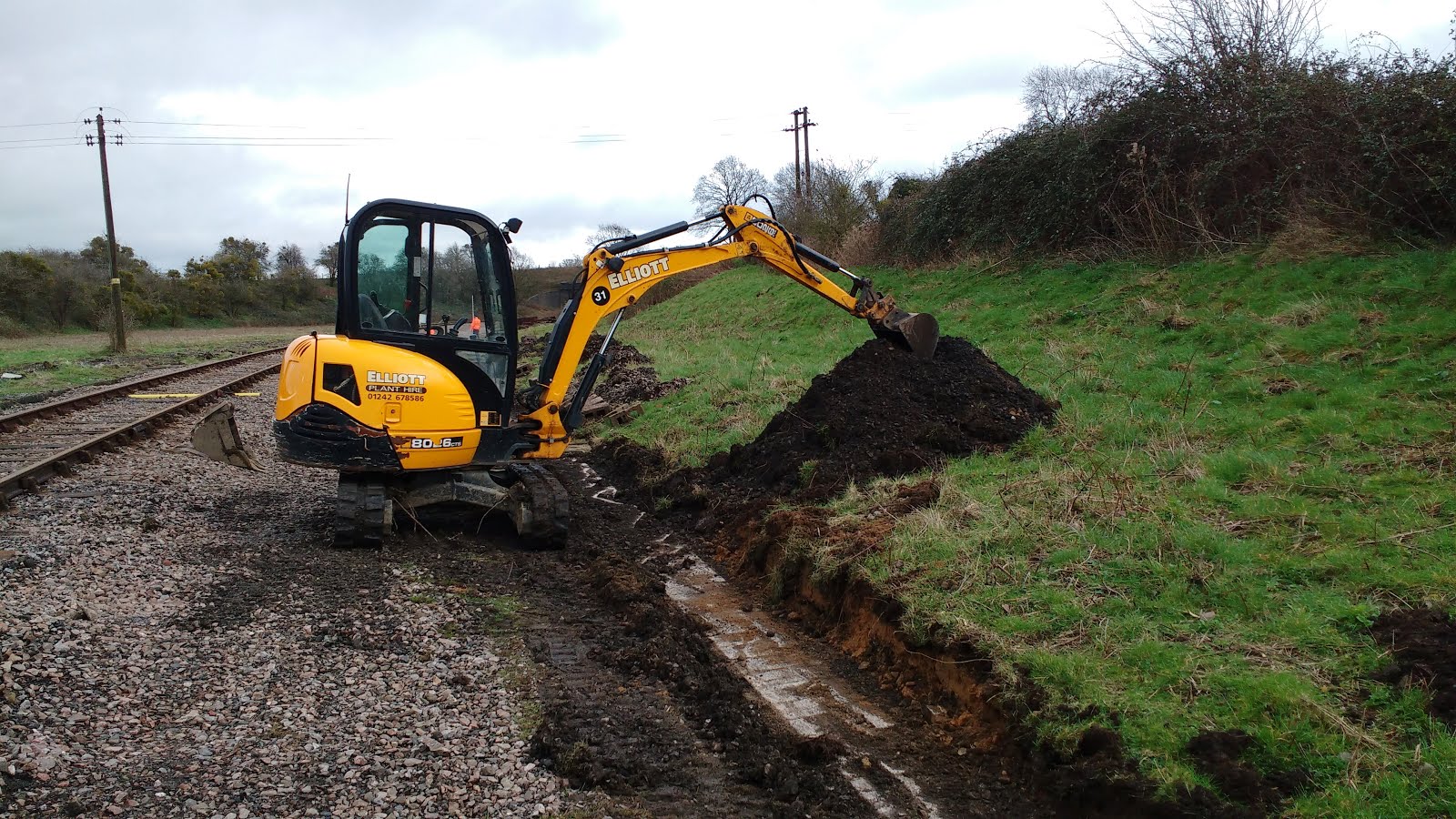

The spoil heap from a 12m stretch of drain
Progress along the cess today


Tuesday 25 February

There was a meeting at Gotherington with the contractors and the design team. It's looking promising for having the slip stabilised ready for reopening on 7 March. It was decided that the soil nails through the slip should be extended to 18m.


Drillers hard at work installing soil nails
The end of the nail waiting for the plate
3m lengths laid out ready for installation
Drilling rig on the bench under the face
Middle row of nails
Discussions in full swing

Stop off on the way past to check how much spoil and aggregate is left at Stanton Yard, not much!

Stanton Yard stockpiles


Thursday 27 February

A bit of a shock to the system this morning, British weather can be changeable. Lego blocks in at Winchcombe cutting down side to retain the toe of the slip and the the 5m steel sheet piles arrived for rail transport down to Bridge 37. Then we had a Health & Safety inspection at Royal Oak, it's good to get a specialist view on what we have planned, it reinforces good practice.

Cotswold morning, almost Spring 😊
Winchcombe retaining wall in place
12 tonnes of 5m steel sheet piles

Added excitement at Royal Oak, the tamping machine passed through this morning on it's way further down the line. Strange to see rail traffic, there hasn't been any since we started here.

Tamping machine running through

First job today was moving the excavated drain blocks nearer the line so they can be loaded onto a trolley to take them to where they can be loaded for transporting off site.

Blocks piled ready to go
Too much water in the trouble spot still
A couple of grips pulled into the slope

More water ponding above the toe on the up side slope, another job on the list

Wet area on the up side slope
Michael and Dieh digging the grip in the crest
Andrew and Martin taking the cess levels on the up side
It's very wet on the down side crest
Water flowing over the crest drain

The down side crest pipe should be intercepting most of the run-off water, it's in a worse overgrown state than the cess drain. It's going to be awkward to get a machine in to excavate it until the ground dries out.

The water goes into the pipe eventually, just not where we need it to

Down at Gotherington it's a summer day almost, the howling wind is a tad fresh though.

Nails laid out ready to go in, the face has crept back to under 3m here
Face at 3.4 m in places now, it doesn't help having a 10 tonne rig on it

News in that the piling machine weighs in at 35 tonnes, getting it in may be interesting

Snout cracking at the toe

It was a different day on the way back, hopefully the snow flurry this morning will be out last for the year.

Cotswolds in the setting sun



Saturday 19 February

Leap year, so we get an extra day for working 😉

It's been raining for the last 24 hours, this calls for a quick check on the bridges that normally flood. Bridge 6 Laverton and Bridge 16 at Didbrook are both in dips and catch quite a bit of surface water, both were clear today. While Michael and Dave went north, Stuart and Roger went to have a quick check on the slip at Gotherington.

Bridge 6 Laverton, gully drains working
(Photo: Dave)
Culvert 16A down side overflow
(Photo: Dave)
Bridge 16, Didbrook No 2, clear
No drilling today, rig parked off the slip
Bridge 37 slip, soil nails in the face
Bridge 37 up side slip at track level
Bridge 37 up side slip, slope toe
Bridge 37 up side slip
Cracks in the snout at the toe
5 m steel piling stacked up at Gotherington

On the way back we spotted that Culvert 31A at Prescott Road has backed up from the outlet. The main issue here is that there is only a 6" pipe between the outlet channel and an overgrown ditch along the roadside.

Culvert 31A, up side outlet backing up
Culvert 31A up side headwall submerged

Round at Working Lane, Michael was preparing the patio area outside the welfare cabin, then we did a bit of road repair on the lane. Even the Transit was scraping the ridge in the middle of the lane, so we needed to sort it out.

Michael with the whacker plate
Dave clearing the end of Culvert 24C again
Culvert 24C up side running again
Michael and Dave spreading the hardcore on the lane
Working Lane one side built up

Roger was back today after a short break, his first job was to inspect the low mileage wing wall on the down side of Bridge 25. The embankment around the end of the wing wall looks to have receded, the red bricks would normally be underground.

Roger working out how to repair the wing wall

The flow on the up side of Culvert 25A is mainly flowing along the ditch at the toe from the outlet of Culvert 25B.

Culvert 25B outlet ditch

Up at Royal Oak, Michael and Dave started to cut back the hedge, we need to get into the crest drain as it has overgrown and the run-off from the field is cascading straight over it.

Royal Oak, Roger off to look at the down side cess
Royal Oak down side, run off from the field into the cess
Michael with the brushcutter on the crest

Down side cess, drain blocks inhibiting the flow
Royal Oak, up side pond
Royal Oak, Dave cutting back the hedge
Royal Oak, another hail shower passing through
Royal Oak up side turning area extended
