Monday 2 March
Multiple jobs on the go today, more work on the turning area, some vegetation removal and removing the blocks to a safe place. At least the weather was fine for once.
|
Royal Oak weather |
In the past we have spent a lot of time and energy shovelling materials on and off the flat bed truck as well as digging holes by hand. So that we can improve productivity, we are moving towards a more mechanised form of working. The excavator is on hire for the Royal Oak work and a couple (or five) other jobs. Plus we have the latest addition; a cheap tipper, this will allow us to move bulk material between sites as well as some of the on-site work. The tipper didn't cost a fortune, in fact it was less that one person's fare for each day of the running season. We'd like to thank that person for their generosity 😊
|
Loading the ballast for the turning area
(Photo: Dave) |
|
Unloading the spent ballast on the turning area
Fast than shovelling it off 😉 |
|

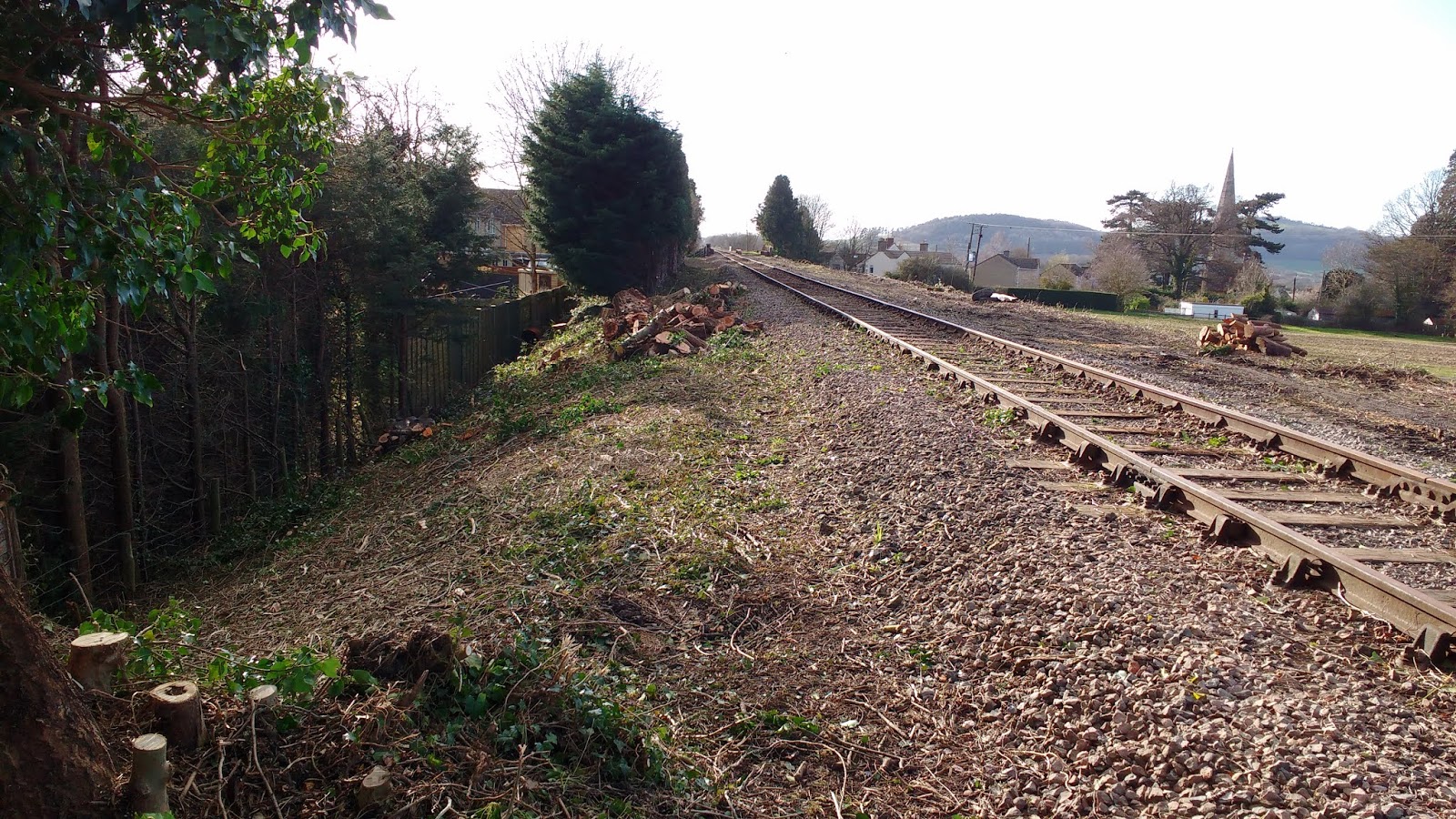

Royal Oak forward operating area |
It's bird nesting season already, so we did a thorough survey of the area to be cleared before starting to remove the brambles.
|
Nigel and Dave clearing the hedge to get to the crest drain. |
|
Run off from the field has slowed down |
|
Clearing the area on the slope next to the former slip site |
The Lineside Clearance team have taken the spindly trees out on the down side between Culverts 24A and 24B. This will allow us to get the kit in to rebuild the culvert headwall.
|
Nigel and Dave with the first trolley load of blocks |
|
Down side cess cleared up |
|
Time for a breather, after the hard work |
Last little job was to measure up Culvert 25A at Working Lane, Gretton to do the design for the rearrangement of the up side flow so that the roadway doesn't collapse into the stream.
|
Culvert 25A down stream |
|
Brick channel on Culvert 25A up side |
|
Flow along from Culvert 25B |
Looking at the outfall of Culvert 25B the water appears to be stagnant, not sure where the flow that reaches 25A comes from.
|
Culvert 25B up side outfall |
|
Culvert 25C up side outfall |
The forestry contractors have been busy along this stretch of line removing the trees that are overhanging the line and causing safety concerns.
|
Working Lane looking West |
|
Working Lane looking East to Winchcombe |
|
Culvert 25A outlet stream from the bridge |
Thursday 5 March
With 5 volunteers in today a lot was going to be done. Martin and Dieh dug out the down side crest pipe at Royal Oak, this was an exploratory dig to see how deep the pipe was, what the covering is, and why it isn't catching the run-off from the field. The answer is that it has a covering of earth that is holding the water so it isn't permeating down to the pipe. The length will need to be dug out and backfilled with stone. The excavation may have to wait until the ground dries as it's a bit precarious to get a machine in on the boggy sloping ground.
Andrew and Michael went to the tunnel portal to clear both sides so that we can see how it is draining. There's a lot of water seeping in through the construction joints in the bore, the drain over the portal will need to be cleaned out.
|
Royal Oak, run off grip drying up showing the pile of silt washed down |
|
Royal Oak, down side crest drain pipe exposed |
|
Greet tunnel high mileage portal |
|
Tunnel down side wing wall |
|
Tunnel up side wing wall |
|
Tunnel down side wing wall and cap stone Water has been running down and over the wall here |
The rest of the day was spent in the cess drain removing more drain blocks and discussing how best to address the issues caused by the blocks. We need to be conscious of the costs of the reinstatement works. It's estimated that over 250 tonnes of stone would be needed to do a full replacement, but a plan is being worked on that will involve a compromise solution using less stone.
|
Andrew, Dieh and Michael in the cess ditch |
|
Martin and Andrew top side, with Dieh and Michael in the wet |
As the team worked along the discovered a last remaining wall from a chamber, the end bricks show where the end walls were broken out. It looks like this trouble spot has a long history 😧
|
Rail side chamber wall uncovered |
|
Hollow blocks removed |
At the run-off collection point, the pipe joints were cleared to let the water run into the pipe.
|
Cess drain pipe with open joints |
|
Open joint on the cess pipe |
|
Next area along to the tunnel |
|
Blocks removed from this one section |
Saturday 7 March
Down to Gotherington to catch the first service train go over the slip repair. All went according to plan, with the loco crew craning their necks to have look down to the shelf. Then, after a bird survey, we cleared the area for the 3rd phase of soil nails. Clearing it now will save any hold ups where expensive machinery is involved.
|
7820 Dinmore Manor tender first over the slip at Bridge 37 |
|
Bridge 37 up side slip, snout still cracking |
|
Water running out of the slope over the haul road |
|
Michael and Roger brush cutting the up side slope |
|
Up side slope area cleared |
Back round at Royal Oak the run off has slowed down considerably, not surprising after a few dry days. The upturn in the weather allowed Michael to get back to brick laying in the crest chamber on Culvert 24A. Roger has taken over mixing duties, while Stuart excavated the the footings for the next chamber and headwall on Culvert 24A up side.
|
Royal Oak down side cess run-off |
|
Exposed silty cess pipe drying up |
In the area further along towards the tunnel an oily film has formed on the water. This is caused by anaerobic organisms working away in the sodden ground. It's a bad sign as it means the drainage isn't working at all.
|
Grip below the old slip, Royal Oak down side cess |
|
Another example of the hollow blocks inhibiting the drainage operation water just can't penetrate into the pipe |
Culvert 24A up side has a no headwall and has a deep scoured channel, this is a hazard for passing traffic on the track above and for the vegetation management equipment. The plan is to pipe it and build a new chamber. Then construct a headwall on the other side of the haul road.
|
Culvert 24A up side exit ditch |
|
Culvert 24A new headwall site |
|
Digging the new chamber footings (Photo: Roger) |
|
Start of the chamber footings excavation |
After many interruptions, the crest chamber has risen above ground today.
|
Michael in the hole again |
|
Roger mixing concrete to go behind the chamber wall |
The up side ditch had a root problem, it took a while to extract, but it's been sorted out.
|
Root canal work 😊 |
|
Work stops for the DMU to roar through |
|
New chamber footing excavation |
|
Headwall footings started |
|
Root removed, after a tussle |
|
Progress on the crest chamber |
